Procurement Financial Efficiency in Construction: A CFO’s Guide to Margin Protection

Procurement Financial Efficiency in Construction: A CFO’s Guide to Margin Protection

Procurement financial efficiency in construction means structuring how external spend is authorized, committed, and tracked so that every procurement decision is connected to budget authority and visible to finance before it creates a liability. For CFOs and finance leaders in development and construction, it is not a back-office operational improvement, it is the primary mechanism through which project margins are either protected or lost.

Construction and real estate development are among the most capital-intensive industries in the global economy. They are also among the least efficient at converting that capital into planned returns.

According to KPMG’s Global Construction Survey, only 25% of construction projects finish within 10% of their original budget. McKinsey Global Institute research puts the average cost overrun at 2833%, across all project sizes, all geographies, all sectors. These are not exceptional outcomes. They are the industry baseline.

Only 25% of construction projects finish within 10% of their original budget, and the average cost overrun is 28–33%.

Source: KPMG Global Construction Survey / McKinsey Global Institute

The causes are well documented: uncontrolled procurement spending, late detection of budget deviations, scope changes without cost tracking, and fragmented visibility into real-time project costs. In other words, procurement failures. Not design failures, not financing failures — procurement failures. The function that controls the largest share of construction project outflows is also the function with the least structured governance in most development organizations.

For a development CFO, this is the problem that matters most. Capital is allocated. Projects are modeled. Return assumptions are built. And then procurement decisions made below the finance waterline, informal subcontract awards, undocumented change orders, and purchase commitments that bypass approval workflows, erode the margin that the financial model assumed would be there.

The path forward is not a contingency budget. It is procurement financial efficiency: the deliberate alignment of procurement decisions with financial governance, so that every commitment is authorized, visible, and traceable before it becomes a liability.

“Most construction margin problems are not discovered at completion. They are created in the first 30% of a project’s procurement cycle, through commitments made without proper authorization, change orders not tracked, and supplier decisions not competitive. By the time the P&L reflects the damage, it is already too late to prevent it.”

Natalie Eksi, CEO at APSentra

Why Construction CFOs Cannot See What Procurement Is Spending

Finance leaders in most construction and development organizations face a structural blind spot: their financial reports reflect what has been invoiced, not what has been committed. A purchase order issued today, a subcontract mobilization instructed by email, a material deposit paid on site, none of these appear in the financial picture until an invoice arrives and is processed. In a typical construction procurement cycle, that lag can be four to ten weeks.

With stable market conditions, this lag is uncomfortable but manageable. In volatile conditions, material price escalation, tightening credit, and compressed project timelines become operationally dangerous. CFOs are making capital allocation decisions, drawdown requests, and cash flow projections based on a financial picture that is systematically incomplete.

Finance workloads are expected to grow 4.1% in 2025, but organizations with high spend visibility achieve 30% better cost savings than those with low visibility.

Source: The Hackett Group, AI-Driven Spend Management, 2025

The root cause is not a technology gap. It is a governance gap. In organizations where procurement decisions are made informally, by project managers acting on established relationships, by site teams ordering on verbal authority, by subcontractors mobilizing on email instructions, there is no structured point at which finance is brought into the loop. The commitment is made. The obligation is created. Finance finds out later.

“In construction, the gap between what has been committed and what finance can see is where margin disappears. Digital transformation in procurement is not about automating purchasing. It is about connecting every spend decision to financial governance at the moment the decision is made, not weeks later when the invoice arrives.”

Dyci Manns Sfregola, CSCP, Founder & CEO at New Gen Architects

This visibility gap has a second consequence beyond the margin: it impairs the quality of decisions made by the CFO. Drawdown requests are based on incomplete commitment data. Cash flow projections undercount near-term obligations. Budget-to-actual reporting arrives too late to enable corrective action. The financial picture that informs executive and lender-facing decisions is not the real picture.

Chart showing gap between committed procurement spend and invoiced spend on a development project — the CFO blind spot

The Three Procurement Decisions That Destroy Development Margins

Across construction and development projects, margin erosion concentrates in three procurement failure modes. Each one is structural, meaning it recurs across projects, not because of individual error, but because the governance conditions that would prevent it are not in place.

Informal Subcontract Awards Without Competitive Process

Relationship-based procurement is the default in construction. Project managers work with subcontractors they know. Repeat awards go to familiar names. Competitive tendering, when it happens at all, is often nominal, a single preferred bidder with two token comparisons to satisfy a process requirement. The financial consequence is systematic. Research consistently shows that structured competitive tendering with pre-qualified vendor pools yields 8 to 15% savings compared with informal single-source awards. On a $5M subcontract package, that gap is $400,000 to $750,000 of avoidable cost, on a single trade. Across a mid-size development portfolio, the aggregate procurement premium paid through relationship-based sourcing is rarely calculated and rarely reported to the CFO.

Change Orders Managed Outside the Budget System

Change orders are the most consistently destructive force in development project finances. They are also the most consistently mismanaged. In organizations without structured change order governance, the sequence is predictable: scope is added informally, the subcontractor proceeds on instruction, the cost crystallizes weeks later, and the budget deviation surfaces at month-end, when it is too late to make a different decision. The aggregate cost of informally managed change orders routinely represents 5 to 15% of total contract value on affected projects. The cause is not dishonesty. It is the absence of a structured workflow that requires finance authorization above defined cost thresholds before additional scope is instructed.

Purchase Commitments That Bypass Authorization Controls

In manual procurement environments, purchase commitments are made through a combination of formal POs, email instructions, verbal agreements, and on-site directions. The formal POs are visible to finance. The rest are not, until the invoice arrives. This creates a category of commitment that finance cannot see, cannot plan around, and cannot prevent in the future if there is no system capturing it. The consequence extends beyond individual transactions. Developers and construction firms with high volumes of off-system commitments consistently produce inaccurate WIP reports, unreliable cash flow forecasts, and budget-to-actual analyses that do not reflect actual project exposure. The financial reporting that lenders, investors, and board members rely on is built on an incomplete commitment ledger.

Procurement-related inefficiencies, change order leakage, invoice errors, and missed sourcing savings can erode 5–20% of a potential project margin. On a $50M project, that is $2.5M–$10M of avoidable loss.

Source: Construction Financial Management Association (CFMA) 2025 Financial Benchmarker

What Procurement Financial Efficiency Looks Like in Practice

Procurement financial efficiency is not a single intervention. It is a set of interconnected governance conditions that, taken together, connect every procurement decision to financial accountability. The following four elements define what that looks like in a functioning development or construction organization.

Pre-Commitment Spend Visibility

Every procurement decision, from purchase request through to subcontract award, is recorded in the system at the moment it is made, not when the invoice arrives. Finance sees the commitment ledger in real time. Budget holders know at any moment what has been authorized, what is pending approval, and what remains available within their authority. Drawdown requests and cash flow forecasts are built on actual committed spend, not estimates.

Enforced Approval Workflows Mapped to Budget Authority

Approval routes are configured to reflect the actual organizational and budget structure: by value threshold, by project, by trade category, by business unit. A subcontract award above a defined threshold requires CFO authorization, and the system enforces this, structurally. Informal procurement and verbal instructions cannot create budget obligations that the finance function has not authorized.

Competitive Sourcing With Documented Evaluation Criteria

Supplier and subcontractor selection are governed by a structured process with pre-qualified vendor pools, standardized scope documentation, and defined evaluation criteria established before the tendering process begins. Preferred vendor status is earned through documented performance, not assumed through a relationship. These disciplines cost at the point of award, rather than attempting to recover them afterwards.

Complete Audit Traceability

Every action in the procurement system, including who submitted a request, who approved it, which supplier was selected, and on what basis, what documentation was provided, is logged and retrievable. This is not primarily a compliance requirement, though it satisfies one. It is the foundation for credible financial reporting on project procurement activity, and for the internal controls that lenders, investors, and boards increasingly expect to see demonstrated.
MetricUnstructured ProcurementStructured Procurement
Change order leakage5–15% of contract value1–4% of contract value
Invoice error/overbilling3–5% of invoicesUnder 0.5% of invoices
Sourcing savings vs benchmark0–3% (informal awards)8–15% (competitive tender)
Commitment visibility lag4–10 weeks (invoice-based)Real-time (PO-based)
Budget forecast accuracyLagging / incompleteForward-committed

Sources: CFMA 2025 Financial Benchmarker; Dodge Data 2025 Construction Outlook; APSentra implementation data.

Evidence from the Field: Two Construction Implementations

The governance model described above is not theoretical. The following accounts draw from two APSentra implementations in the construction sector. Client identities are confidential; the outcomes are not.

Case 1: Residential Developer — Closing the Conditions for Procurement Leakage

Challenge: Budget estimates were tracked separately from actual procurement activity, with no automated link between commitments and financial reporting. Supplier selection was driven by informal relationships rather than objective criteria. There was no audit trail for user actions.

APSentra Solution: Implemented end-to-end sourcing automation: electronic tenders, reverse auctions, and automated approval routing, configured to mirror the full depth of the client’s project hierarchy from headquarters through to individual construction sections.

Outcome: Supplier decisions are now governed by standardized, documented criteria applied consistently across all tenders. The gap between budget estimates and procurement execution, the gap through which financial leakage had previously operated, was structurally closed. Finance gained real-time visibility into committed spend across all project levels without relying on manual reporting.

“Automation is one of the most powerful tools against corruption. When the process is automated, transparent, and tied to objective KPIs, there is simply no space left for shadow activity.”

— Project Lead, APSentra

Case 2: Infrastructure Contractor — Building a Continuous Procurement-to-Receipt Chain

Challenge: Procurement and logistics operated as disconnected functions, with no systematic link between purchase requests, supplier orders, delivery coordination, and warehouse receipts. Discrepancies between what was ordered and what was delivered accumulated undetected.

APSentra Solution: Deployed an integrated procurement and supply chain control solution built around six modules: Request, Tender, Contract, Order, Receipt, and Analytics. Every line item moves automatically through the full sequence, with data carried forward between stages without manual re-entry.

Outcome: every purchase is now traceable from request to receipt, with no manual handoffs and no unverified deliveries. Leadership has consolidated procurement and supply chain analytics across all active project sites, structured for executive review, not operational reporting. The audit and security function has the controls and data it needs to monitor compliance continuously.

“The goal was to build a control mechanism that covers the entire chain, from purchase request to goods receipt. That mechanism is now in place.”

— Project Lead, APSentra

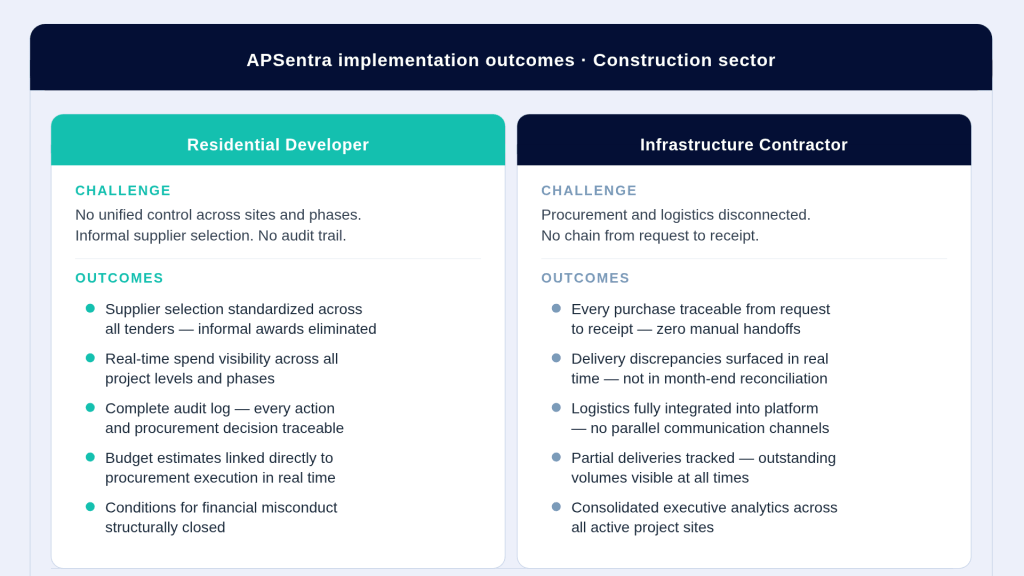

Summary of APSentra construction procurement implementation outcomes, spend visibility, audit trail, and margin protection results

The CFO’s Four-Question Diagnostic

Before a CFO can determine which governance changes are needed, they need an accurate picture of where their current procurement environment stands. The following four questions provide a rapid diagnosis. They require no technology, only honest answers from the people who run procurement and project finance.

  • How much time passes between a procurement commitment being made and finance knowing about it?
    • If the answer is measured in weeks or is genuinely unknown, the commitment ledger is not live. Financial reporting is lagging.
  • Can your organization produce, within 24 hours, a complete list of all spend commitments currently outstanding across all active projects, by project, by trade, by approval status?
    • If not, the visibility required for credible cash flow forecasting and drawdown planning doesn’t exist.
  • What proportion of subcontract awards in the past 12 months were made through a competitive process with documented evaluation criteria?
    • If the honest answer is below 50%, the organization is systematically paying a sourcing premium.
  • How are change orders governed? Is there a defined workflow that requires finance authorization above a cost threshold before additional scope is instructed?
    • If a change order governance is informal, budget protection is informal.

An organization that can answer all four questions confidently has procurement financial efficiency in place. An organization that cannot answer one or more of them has identifiable, addressable gaps, each of which has a documented financial consequence.

APSentra: Procurement as a Financial Control System

From request to contract and reporting in one governed platform.
Book a Demo

About APSentra

    Don’t miss an article

    Get the latest procurement and spend management insights in your inbox.
    By submitting your information, you agree to our Terms of Service and Privacy Policy.
    Written by:
    Aps entra
    Natalie Eksi
    [email protected] Natalie is a global procurement and supply chain leader focused on turning procurement into a strategic, finance-driven function. She helps organisations modernise procurement processes to improve transparency, efficiency, and cost control. Natalie connects experts across regions to accelerate the adoption of modern procurement technologies and scalable operating models.
    Aps entra
    Dyci Manns Sfregola
    [email protected] Dyci is a supply chain and digital transformation advisor focused on helping organizations modernize operations through technology, process optimization, and cross-functional alignment. She works with business leaders to improve operational efficiency, accelerate digital adoption, and support scalable growth across complex environments.

    Frequently Asked Questions

    01.

    What is procurement financial efficiency in construction?

    Procurement financial efficiency in construction means structuring how external spend is authorized, committed, and tracked so that every procurement decision is connected to budget authority and visible to finance in real time. It covers competitive sourcing discipline, enforced approval workflows, change order governance, and complete audit traceability, taken together as a financial control system, not as isolated operational improvements.

    02.

    Why do construction projects consistently go over budget?

    Research from McKinsey and KPMG consistently identifies procurement governance failure as a leading cause: uncontrolled spending, late detection of deviations, scope changes without cost tracking, and poor real-time visibility into committed costs. The financial reports that CFOs rely on are typically invoice-based, not commitment-based, creating a systematic lag between when costs are created and when they become visible.

    03.

    How does structured procurement reduce project cost overruns?

    Structured procurement reduces overruns through four mechanisms: competitive tendering produces better pricing at the point of award; enforced approval workflows prevent unauthorized commitments from accumulating; formal change order governance stops scope additions from bypassing the budget; and real-time commitment tracking gives finance the data needed to intervene before a deviation becomes unrecoverable.

    04.

    What is the difference between committed spend and invoiced spend in construction?

    Committed spend is the financial obligation created when a purchase order is issued or a subcontract is awarded, the moment the organization becomes liable. Invoiced spend is what appears in financial reports when an invoice is processed, typically weeks or months later. In most construction organizations, CFOs can see invoiced spend clearly, but committed spend only partially, creating a blind spot that impairs forecasting, drawdown planning, and budget control.

    05.

    How long does it take to implement structured procurement governance in construction?

    Implementation timelines depend on organizational complexity and how much governance structure exists already. Based on the APSentra construction implementations described in this article, operational deployment, including configuration of approval workflows, tender modules, and analytics, was completed within eight weeks. The prerequisite is organizational clarity on approval authorities, budget structure, and vendor qualification criteria; technology operationalizes governance decisions, but it does not substitute for them.

    06.

    Where can I read the full APSentra construction case studies?

    The full case studies, covering the residential developer and infrastructure contractor implementations described in this article, are available at the APSentra case studies page.
